Application Administrator, Project Managers or Resource Managers can manage the
employee assignment to projects. While Project Managers can assign employees
to only those projects where they are the Project Manager the Application Administrator
or Resource Manager can assign them to any active project. Activities which can
be done on this tab are -
1. Assigning employees to project - this can be done either in bulk through excel
upload or through a table
2. Removing employees from project
3. Maintaining data of Planned Loading %, Planned Hours, Billable / Non Billable
flag, Rate for employees on a project
4. Maintaining cost and billing rates
An employee can be assigned to a project multiple times. For example he might work on a project from 1-Jan to 15-Feb and then again from 1-Mar. These tenures are recorded as separate assignments on the project and each will have separate Planned Loading %, Planned Hours, Billable / Non Billable flag, Rate details.
1. Assigning employees to a project
Employees
can be assigned to a project either through a bulk mapping process or manually
from the table. To map employees to a project select the name of project as shown
below. You will see a list of all active employees in the company.
2. Click on "Add to Project" button on the last columns or select multiple employees and click on "Add to Project" button on top of the table to add employees to a project. Employees will receive an alert when they are added to the project
3. You can check the current assignment of the employee across all projects by clicking on the hyperlink on the Employee Name. A popup as shown below will open up
Note – If employee is assigned to some other projects in past then anyway pending timesheets for that period would have been created or timesheets would have been submitted and there will be no change to those submitted / approved timesheets. If time has to be booked on approved timesheets for projects which have been mapped to an employee later then only Project Manager of the project can update (this is linked to Timesheet parameter "Allow updation of approved timesheet", refer article for more details.

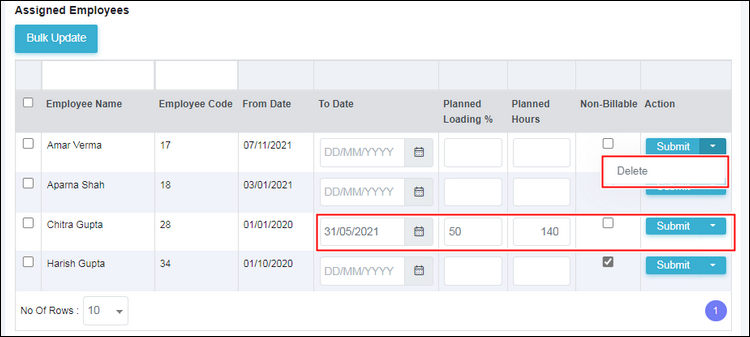

3. Updating details of a mapped employee
Note - You cannot remove to employee from a Default project. Refer article "Managing Projects" for more details.
4. Past Assignment

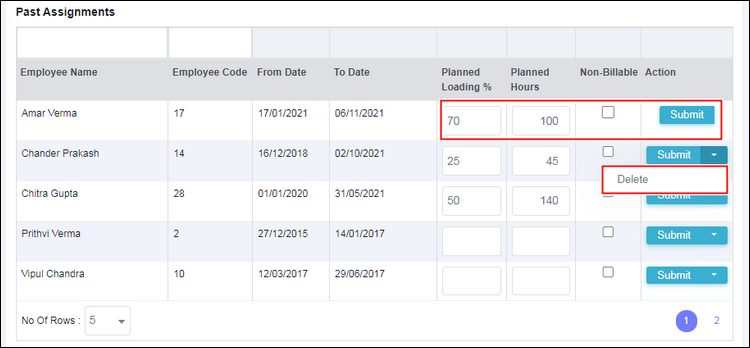

On this table you can review all past assignments where employees have rolled off from a project. You can update the Planned Loading %, Planned Hours and Non-Billable flag. If you want to reverse the roll-off you can use the Delete button, this will delete the To Data and assign the employee back to the project.
5. Resource Costs and Rates
Costs and rates for all employees who have been mapped to the project can be
updated through the table as shown below.
The currency for costs and rates is picked up from the currency mapped to project.
